System Boundaries |
For
an LCA to be exhaustive, according to our time for the project, we set
some boundaries to work the LCA. System
boundaries that included in our study:
System
boundaries that omitted from study:
|
Impact Factors |
In
order to assess the LCIA, we required some impact factors on which to base
our analysis. The ISO stds for LCA do not provide impact factors on which
to judge the LCIA, however from the literature review it was decided that
the most appropriate impact factors were contained in the CML methodology.
These were:
|
The Building |
In order to carry out an LCA analysis, we first had to find a suitable building for using as a case study within our project. This required detailed records of the materials of construction, with an inventory breakdown of the required amounts of each material within the building construction. After consultation with various contacts, including architectural firms, university lecturers and post-graduate students, we finally decided on using the plans for a school in Glasgow, which had previously been studied by one of the post-graduate students within the university and which an ESP-r model had been constructed. The reason for using this building was that the LCA is a very complex process and by using this model, we were able to obtain a full material inventory breakdown and also model the energy use of the building which would otherwise have been very difficult to achieve in the project time-frame. In order to simplify the LCA further, we chose one classroom from the model on which to base our LCA study. Through consultation with an electrician, we were able to produce a wiring diagram of this room and also carry out an LCA on the wiring system, which will be explained later. A diagram of the ESP-r model of the classroom is shown below with each part of the room labelled: |
Functional Units |
To provide a baseline for objective comparison of the building and the wiring system, we had to have equivalency between the two systems in order to effectively compare the different materials of construction within the building and the cable. Therefore, in order to normalise the results from the classroom and the wiring system, we chose the functional units, as mass of material. This normalisation of all the different materials allowed a comparison of the impacts of each material to be carried out. |
Life Cycle Assessment |
In order to compare all the impacts of the building versus the wiring system, all energy and material flows throughout the life cycle of both the building and the wiring system must be taken into account. |
|
The total manufactured mass of construction material may not necessarily be equal to the material mass used to construct the room, due to losses occurring in the manufacturing stage, transportation stage and construction stage. Using the data from the ESP-r model, we were able to obtain the required construction mass of each building material. Volume
of each material = Thickness x Surface Area Mass of material = Volume x Density All calculated material masses are shown in Figure 1 NB/ the materials of construction are shown as they appear in the ESP-r model for simplification. Notice that for each room portion, there appears to be some materials mentioned twice. This is a function of the ESP-r model, which is required for accuracy, as the material is divided into several parts due to the position of the nodal points within the software. Both portions account for the total material usage. However, as stated previously, the construction mass for the building incorporated all the losses mentioned previously (manufacturing, transportation, construction). In order to calculate the total manufactured mass, we must obtain data of the expected losses during manufacturing, transportation and construction of each of the materials within the classroom. This data has been taken from previously published data. Calculating the
total manufactured mass of material, incorporating all the expected losses
is an iterative procedure working in reverse order from manufacture. The
transport losses to the construction point should be calculated first,
then the transport losses to the pre-fabrication point (if required)

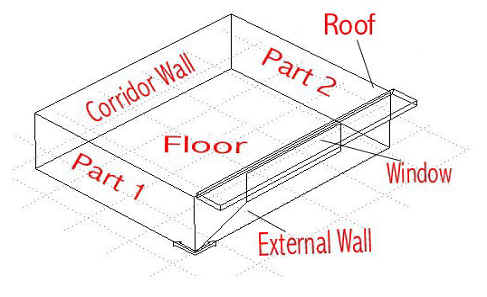

should be taken into account. As can be seen from Figure 2,
only the window is a pre-fabricated unit, which requires transportation
distances from pre-fab site to construction site. Finally, losses in the
manufacturing phase should be accounted for. What has not been mentioned
is that each construction material has a finite lifespan, which may be
less than the classroom lifespan. If we look at mineral fibre as an
example, the expected lifespan of this material is 30 years. If we carry
out the LCA over a period of 70 years, then this would require at least 2
replacements of this mineral fibre, one after 30 years and another after
60 years. In practice this would be unlikely due to the fact that the
second replacement would probably not occur, since the building will be
decommissioned only 10years after the replacement. If we look at this in
numerical terms: Building lifespan =
70years Material lifespan =
30 years No. of material
loads of mineral fibre = 70/30 = 2.3333 In practice the
effective number of times that a material is replaced in a real building
corresponds to a round number (integer). Therefore, we have assumed that
the no. of material loads will be rounded to the nearest integer, which
gives us the number of replacements over the building lifespan. Therefore the
number of material loads of mineral fibre required will be (2.3333),
rounded to the nearest integer = 2. Taking into account all losses and replacements of construction materials, gives us the total manufactured mass of each building material as shown in Figure 3. |
Transportation |
Transportation
also has a value associated to each of the impact factors, by which we are
assessing our LCA, depending on the vehicle size and type. In
order to calculate the impacts associated with the transportation of each
material, the manufacturer of each building material must be known.
At this stage however, due to the fact that we did not have a bill of
materials from the actual building, we had to make a best approximation of
the material manufacturers, and we did this by visiting various building
material merchants to find the most popular manufacturers for each
construction material. This allowed us to estimate the manufacturer and
the distance from the manufacturing point to the construction site. In order to accurately assess the transportation impacts associated with construction of the building, the vehicle types must be known also. Again, this level of detail was unavailable to us, therefore as a best approximation, we used the same modes of transport for each material as had been used previously in a PhD research study for a building constructed in Switzerland. The two types of transport required for material transportation for the materials used in the classroom construction, were a 16ton lorry and a 26ton lorry. The
manufacturers and associated transportation distances are shown in Figure
4. |
Environmental Impacts |
Each stage of the LCA process, from material manufacture, to transportation, to material elimination has a value associated with each of the chosen impact factors, which allows a comparative evaluation to be carried out. |
When
examining the manufacturing process of the construction materials, each
material has a value associated to the impact factors that we have chosen
for doing our LCA study. The manufacturing impacts for all the
construction materials are shown in Figure
5. These impacts take into account raw material extraction,
transportation of raw material to extraction point and the energy used in
the manufacturing process. NB/ from the figure 5, the values of each manufacturing impact are related to the production of 1 kg of material. In order to find the total manufacturing impact for each material, we require to multiply by the total manufactured mass. The total manufacturing impacts for our construction materials are shown in Figure 6. |
When examining the transportation of the construction materials, each transportation type has a value associated to the impact factors that we have chosen for doing our LCA study. Two types of transportation were identified as being inclusive within our study - transportation from 16 ton and 28 ton lorries. The impact values associated to these two types of transport are shown in Figure 7. NB/ the impacts are related to tons x km of material. Therefore in order to calculate the total transportation impact of each material, we must multiply these impact values by the total manufactured mass of each material and the distance that is travelled in km (refer to figure 4). This gives us the total transportation impacts as shown in Figure 8. NB/ It should be mentioned that the density of the construction material has an effect on the transportation impact i.e. the number of journeys required for transportation of each material may differ depending on the material density, because of the transported material volume. Due to the fact that we were studying one room only, then we assumed that each construction material would be able to be transported to the construction site by one journey only. |
In
order to calculate the energy required during the use-phase of the
building, we ran the ESP-r model to obtain the Joules required throughout
one year. This value was multiplied by the assumed building lifespan (70
years), to obtain the total energy required throughout the life span of
the building. We found that the total energy required for the classroom throughout the life span of the building was 2.828E+06 MJ. In order to assess the total impacts of the energy used within the building, we required impact values for the electricity (we have assumed that the total energy used will be from an electricity source. Within the classroom, this may not be strictly true, however electricity produces the highest impacts per MJ used, so this will produce a worst-case estimate). The impact factors for electricity produced within the European union are shown in Figure 9. (These figures represent the impacts per MJ of electricity used which account for both the production and use of the electricity). To calculate the total impacts of the use phase, the amount of energy used within the building (2.828E+06 MJ) was multiplied by the impact factors shown in figure 9. The total impacts are shown below in Figure 10. |
The calculations for the Elimination phase of the building are based on a similar principle to those carried out for the pre-use phase. The disposal processes for each construction material (whether it be landfill, incineration, or recycling) have a value associated with each of the impact factors mentioned previously. The disposal method of each construction material requires to be known with corresponding transport distances to the disposal point. Quantifiable values for the elimination phase are very difficult to obtain so as a best approximation, we referred to a study carried out on a previous building assuming the same elimination phase values, but making a best approximation of the transport distances to the points of disposal. These are shown in Figure 11. As
can be seen from Figure 11, there are 3 variations in the waste
disposal processes of all the building materials, which were recycling,
incineration and landfill. Each of the disposal processes has both an associated transport impact and disposal impact. The transport impacts were calculated as shown previous (refer to Figure 7). Each of the disposal processes has a value associated with the impact factors chosen for carrying out the assessment. These are shown in Figure 12. We
were unable to find data for the incineration impacts of both block and
concrete so the incineration impacts of both these materials were not
included in the study. It should be noted however, that only 1% of these
materials were incinerated (refer to Figure 11), therefore the
impacts from incineration of these materials should be relatively small. |
Having
carried out all calculations as listed above, this gave us quantifiable
values for impacts associated to each of the three phases of the building
i.e. pre-use, use and elimination phases, which could be compared to show
how much environmental impact each phase accounted for. The results are plotted in graphs shown below: It can evaluated from the charts above, that the use phase of the building completely dominates the life Cycle Analysis of the building over a period of 70 years. |
|
Wiring |
The Product |
The
products we choose were from the Pirelli cables. For the room we estimated
after the help of an electrician that we are gone use four types of
cables. a) Lighting circuit – 6241Y/6242Y/6243Y to BS 6004 2-core cable of 1.5/1.0 phase/cpc dia 4.7*8.2 mm b) Electrical ring circuit - 6241Y/6242Y/6243Y to BS 6004 2-core cable of 2.5/1.0 phase/cpc dia 5.3*9.9 mm c) Emergency lighting - 6241Y/6242Y/6243Y to BS 6004 2-core cable of 1.0/1.0 phase/cpc dia 4.7*8.2 mm d) Smoke alarm – FP200 Flex to BS 6387 2-core
cable 1.5 csa dia 8.2mm The
design life of the above products is a minimum of 20 years, but we expect
that in reality it would be greater than 30 to 40 years. Most 1.0mm2 and 1.5mm2 cables in houses have either a 5 or 6 amp fuse attached. Most
2.5mm2 cable is used in ring circuits and have either 30 or 32 amps fuse
attached. Then
we estimated the meters of each type of the cable that will be used in a
room of 69.7 mm2. a) Lighting ring – 22m for 6 ceiling lights evenly placed on the ceiling and exiting through the ceiling. b) Electrical socket ring – 40m for 2 sockets on each wall and circling the room in a main ring and leaving through the ceiling. c) Emergency lighting – 10m for 2 emergency lights placed centrally in the ceiling. Smoke alarm – 15m for 1 smoke detector placed in the centre of the ceiling and 2 break-glass fire alarms on each side of the room again exiting through the ceiling. |
Building Wire Products |
||||||||||||||||||||||||||||||||||||||||
Pirelli can supply a full range of low voltage building wire products, which are commonly used in construction wiring. PVC, AFUMEX and Fire Performance product ranges are available, tailored to meet the requirements of national markets around the world. Our building wire products are manufactured and tested in accordance with international harmonised standards or local specifications.
|
Environmental
characteristics and recourse demand |
General Information |
In the following the products are described. The
environmental impacts have been studied for the three main phases of the
cable system life cycle.
|
Analysis of the process |
After we choose the type of cable that we are gone use, the next step was to find for each one of them the different materials that included in each cable Figure 17. With the help of Pirelli we find the proportion of each materials weight for 1 km cable and multiplied it with our known length for each cable. By also knowing that the design life of the cables was 35 years and our life cycle analysis was for 70 we took the decision to replace once all the cables in the room and so with this we found the total mass that we are gone use for a lifetime of 70 years. Also an assembly loss of 3% was calculated for all the materials. Example:
Lighting circuit- PVC The mass per km for the PVC is 48,4 kg/km and our required meters are 0,022 km. So the total mass of the material is 1,0648 kg. Because we took the decision to replace the cable once, then we had to multiply the mass of the material by 2 so to have the new mass of 2,1296 kg. By calculating the assembly loss that is 3% we came with the total mass of 2,193488 kg. The same procedure has been followed with all the other materials. |
The next step was to assess the impact that the cables material weight will have on the environment. By using the four indicators (NRE, GWP, AP, POCP) we could calculate the total impact to the environment during the manufacturing process for each one of the cables Figure 18 Example:
Lighting circuit- PVC The indicators for the PVC are NRE = 8,443E+01, GWP = 3,931E+00, AP = 2,424E-02, POCP = 8,917E-03. By multiplying the indicators with the total mass of the PVC we get the environmental impact for the material. NRE = 1,852E+02, GWP = 8,623E+00, AP = 5,317E-02, POCP = 1,956E-02. |
Before calculate the use phase of the cables we had first to find the impact in transporting the cables from the manufacturing site to our school. Even though that the total mass of the cables was extremely low we used as a transport mean a lorry of 16 tonnes and this because we wanted to have as much as we could accurate results. The distance from the manufacturing site was obtained by taking consider the Pirellis factory in Hampshire. The impact values for the transport mean were taken from the same databases as for the materials see Figure 19. Example:
Lighting circuit The distance from the Pirellis factory to our school was estimated that is 650 km but because we take consider that the lorry will return then the total kilometres is 1300 km. As we mentioned before the mean was a lorry of 16 tonnes and the indicators for it is NRE = 5,829E+00, GWP = 3,713E-01, AP = 3,205E-03, POCP = 3,307E-03. The unit we use to multiply with the indicators was tkm (tonnes * kilometres). Because the cable goes to the site ready we add the masses of the two materials (PVC + Copper = 3,757028 kg) and convert them in tonnes. So our unit for the lighting circuit is 4,8841364 tkm and the impact for each indicator becomes NRE = 2,8468E+01, GWP = 1,8136E+00, AP = 1,5652E-02, POCP = 1,6151E-02. |
For the use phase we calculated the total energy losses in cables for the time of 70 years. From the known cables we knew the conductor resistance for 1 km and the current that pass through the wires. From these two we could calculate the energy loss of a cable for a length of 1 km, by using the type of P = I2*R. From the extracted numbers we were multiplied them with the total time (in sec) in a period of 70 years to get the total energy losses. Because the room was a school class the using of the power all day for 70 years wasn’t correct, so we multiplied it with a correction factor of 0,7 to have better results. From the database we found the impact for the consumption of energy that was calculated by taking the indicator values for the UCPTE see Figure 20. Example:
Lighting circuit The conductor resistance for the lighting circuit is 12,1 Ohm/km. To find the energy losses we multiplied it with the square of the current that passes the wire (for this case 6A). The energy losses per km was 435,6 W/km and for the given length of the wire (0,022 km) the total loss is 9,5832 W. To find the energy loss for 70 years we calculate the time in seconds for the period of 70 years and we multiplied it with our energy loss together with a correction factor of 0,7 to get the final energy loss of 14,81 MJ. The indicators for the energy consumption are NRE = 3,555E+00, GWP = 1,681E-01, AP = 1,201E-03, POCP = 2,441E-04 and by multiplying them with our energy loss the impact from the lighting circuit becomes NRE = 5,264E+01, GWP = 2,489E+00, AP = 1,779E-02, POCP = 3,615E-03. |
The
last step was to calculate the impact of the cables during the disposal
phase see Figure 21. So in this
stage first we estimate the impact of the transport to the landfill site
and after the impact that the waste will have on the environment. We
decided to find the impact for the landfill site and not for the recycling
or the incineration because is more common after the use of the cables to
through them in the landfill and not separate each material to recycle it
or incinerate it see Figure 22.
Because we didn’t had the information that we needed to calculate the
impact of the waste we forced to use from the database a common factor (Inerte
waste) for all the materials so the final results aren’t as accurate as
we would like see Figure 23. Example:
Lighting circuit To find the transport impact we followed the same steps as previously mentioned in the “transport impact” table. The difference was only in the distance from the school to the landfill. Our new distance was 100 km including the return of the lorries. So the new tkm unit was 0,375703 tkm and the total impact NRE = 2,190E+00, GWP = 1,395E-01, AP = 1,204E-03, POCP = 1,242E-03. As we mentioned before because we didn’t had information about the impact of each material when it becomes waste we forced to use common indicators for all the materials. So the indicators we used was NRE = 8,226E-03, GWP = 5,570E-04, AP = 5,289E-06, POCP = 5,748E-06 and by multiplying them with each one of our cable weight the final impacts were NRE = 3,091E-02, GWP = 2,093E-03, AP = 1,987E-05, POCP = 2,160E-05. |
After
we finished the calculation of the environmental impact for all the three
phases together with the transportation stages we gather all the results
in one table to compare the stages for each indicator between them. From
the boundary definition we decided that the two transport processes would
be added in the manufacturing and in the disposal phase respectively. By
observing the results through the use of graphs we can see that in the
indicators of NRE and GWP the manufacturing
and the use phase are the most important stages. The NRE
shows as that the largest amount of energy consumed is for the manufacture
of the product and in the use and also that these two extract the largest
amount of CO2 in the atmosphere something that harms the environment. In
the AP and POCP
indicators the manufacture phase seems to be the main responsible for
extracting substances such as SOx and C2H4. Also we can see the negligible
impact that the elimination phase has in the four measured indicators. From the percentage graph we can see how much each phase counts to the overall impact of the cables. In the NRE indicator we can see that the manufacturing phase counts the 50,5% the use phase 49,2% and the disposal only 0,3% of the total energy consumption. The same goes with the GWP (CO2 emissions) indicator were 52,75% counts to the manufacturing phase the 46,85% to the use phase and 0,4% to the disposal phase. In the AP indicator the manufacturing phase counts almost the 2/3 = 71% of the total impact compared to the use phase 28,62% and the negligible impact of disposal 0,38%. In our last impact indicator POCP the manufacture is the dominate factor with 99,48% instead of the negligible use 0,49% and the disposal phase 0,03%. |
In
order the results of the impacts to be clearly for the audients, we
produce graphs for each impact factors, of a comparison of the Building
impacts with the Cables impacts. For the Acidification Potential impacts as shown on the table below the impact for the building pre use phase is 1.539E+02Kg SOx-equiv and for the cables at that phase are1.492E+00Kg SOx-equiv. At the at the use phase of the building the impacts are 3.396E+03Kg SOx-equiv and the cables are 6.013E-01Kg SOx-equiv. For the elimination phase the results we got were: for the building 1.594E+01Kg SOx-equiv and for the cables 6.143-03Kg SOx-equiv. Finally for Photochemical Ozone Potential we got that the impacts for the pre use phase of the building are 1.103E+01Kg C2H4-equiv.+NOx and for the cables are 2.438E+01Kg C2H4-equiv.+NOx. Also for the use phase of the building the impacts are 6.903E+02Kg C2H4-equiv.+NOx and for the cables are 1.222E-01Kg C2H4-equiv.+NOx. At last the impacts of the elimination phase of the building are 1.487E+01Kg C2H4-equiv.+NOx and for the cables are 6.3455E-03Kg C2H4-equiv.+NOx which is almost negligible. The impact associated with the photochemical ozone potential for the cables, produces slightly higher results than for the other impact factors. In numerical values, the cables accounted for approximately 3% of the total POCP impacts. It should be noted however that due to time constraints, we did not take account of bulb replacement in the lighting circuit, or fuse resplacement for all circuits which would have an increased impact on the wiring system. What is visible from this is that the LCA of any product, is dependant on the impact factors that are chosen for assessing that product, and that various impact factors need to be chosen in order to get a balanced assessment of said product. It is not enough to judge a product on one impact factor alone, and carrying out an LCA does not give a definitive indication of the sustainability of that product. |
